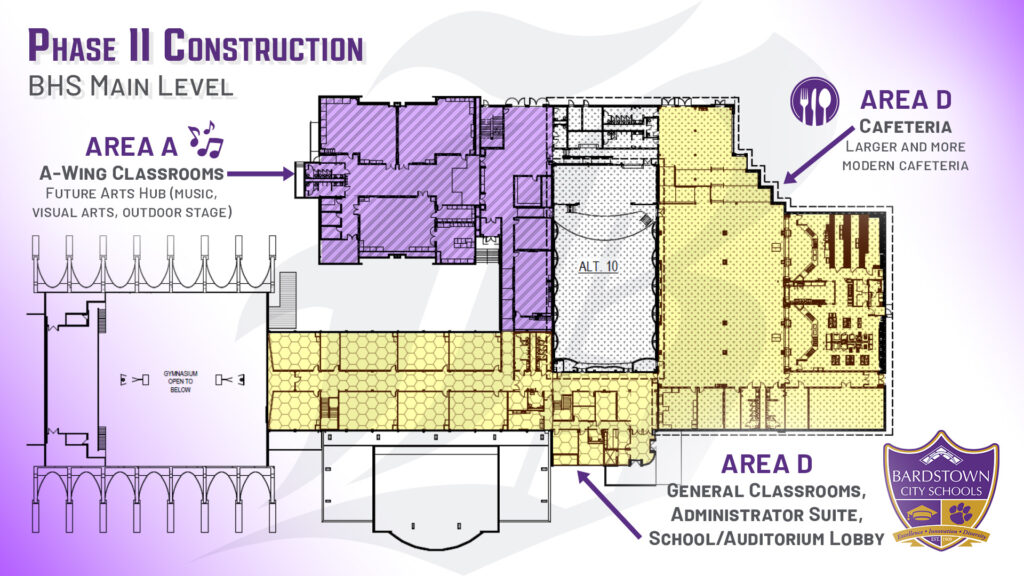

Area A – A Wing Classrooms
The A Wing will be transformed into a hub for the arts. Classrooms will be redesigned for strings, chorus, band, and visual arts, creating specialized learning spaces that match the needs of our growing arts programs. Plans also include an outdoor performance space that will give students new opportunities to share their talents with our school and community.
-
- Anticipated demo start date: September 2025
- Anticipated completion date: March 2027
- Current progress: The Mechanical area demo is 90% complete. Once interior walls are removed and debris cleared, demolition of the catwalk and the center portion of the A Wing will begin.
Area B – Gymnasium
Renovations to the interior of the gymnasium will include painting, a new court, and a new scoreboard, providing students with updated athletic facilities.
-
- Anticipated start date: June 2026
- Anticipated completion date: October 2026

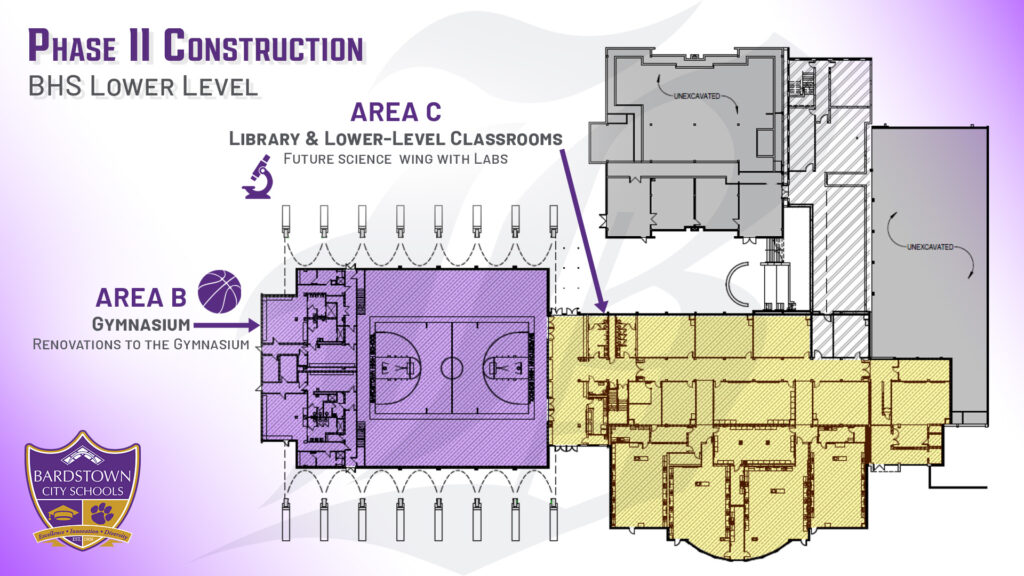

Area C – Library & Lower-Level Classrooms
The lower-level classrooms will receive a full renovation, including updated infrastructure and modernized learning spaces. The current library will be transformed into a science wing with labs for chemistry, biology, earth sciences, and physics, providing students with hands-on learning and exploration opportunities. During construction, the library will temporarily relocate to the Bardstown Polytechnic Center, with plans for a new library space in a future phase of the Fifth Street Renovation Project.
Area D – Cafeteria
The current cafeteria will be demolished to make way for a larger and more modern cafeteria designed to meet the needs of students and staff on this campus.
We are excited to see Phase 2 moving forward and grateful for the patience and support of our students, families, and staff during construction. These renovations will create modern, innovative spaces designed to enhance learning for our 6–12 grade students for years to come.
Our construction partner, Codell Construction, has provided updated maps to help families better understand the progress taking place and the timeline for each phase. We hope our updates spark excitement about the spaces we are building together for our school community!
For ongoing construction updates, visit our Fifth Street Renovation site: https://bisd.fyi/5thStreet
-
- Anticipated demo start date: September 2025
- Anticipated completion date: March 2027
- Current progress: The Mechanical area demo is 90% complete. Once interior walls are removed and debris cleared, demolition of the catwalk and the center portion of the A Wing will begin.
Area B – Gymnasium
Renovations to the interior of the gymnasium will include painting, a new court, and a new scoreboard, providing students with updated athletic facilities.
-
- Anticipated start date: June 2026
- Anticipated completion date: October 2026
Area C – Library & Lower-Level Classrooms
The lower-level classrooms will receive a full renovation, including updated infrastructure and modernized learning spaces. The current library will be transformed into a science wing with labs for chemistry, biology, earth sciences, and physics, providing students with hands-on learning and exploration opportunities. During construction, the library will temporarily relocate to the Bardstown Polytechnic Center, with plans for a new library space in a future phase of the Fifth Street Renovation Project.
Area D – Cafeteria
The current cafeteria will be demolished to make way for a larger and more modern cafeteria designed to meet the needs of students and staff on this campus.
We are excited to see Phase 2 moving forward and grateful for the patience and support of our students, families, and staff during construction. These renovations will create modern, innovative spaces designed to enhance learning for our 6–12 grade students for years to come.
Our construction partner, Codell Construction, has provided updated maps to help families better understand the progress taking place and the timeline for each phase. We hope our updates spark excitement about the spaces we are building together for our school community!
For ongoing construction updates, visit our Fifth Street Renovation site: https://bisd.fyi/5thStreet
-
- Area A – A Wing classrooms
- Area B – Gymnasium
- Area C – Library and lower-level classrooms
- Area D – Cafeteria
Area A – A Wing Classrooms
The A Wing will be transformed into a hub for the arts. Classrooms will be redesigned for strings, chorus, band, and visual arts, creating specialized learning spaces that match the needs of our growing arts programs. Plans also include an outdoor performance space that will give students new opportunities to share their talents with our school and community.
-
- Anticipated demo start date: September 2025
- Anticipated completion date: March 2027
- Current progress: The Mechanical area demo is 90% complete. Once interior walls are removed and debris cleared, demolition of the catwalk and the center portion of the A Wing will begin.
Area B – Gymnasium
Renovations to the interior of the gymnasium will include painting, a new court, and a new scoreboard, providing students with updated athletic facilities.
-
- Anticipated start date: June 2026
- Anticipated completion date: October 2026
Area C – Library & Lower-Level Classrooms
The lower-level classrooms will receive a full renovation, including updated infrastructure and modernized learning spaces. The current library will be transformed into a science wing with labs for chemistry, biology, earth sciences, and physics, providing students with hands-on learning and exploration opportunities. During construction, the library will temporarily relocate to the Bardstown Polytechnic Center, with plans for a new library space in a future phase of the Fifth Street Renovation Project.
Area D – Cafeteria
The current cafeteria will be demolished to make way for a larger and more modern cafeteria designed to meet the needs of students and staff on this campus.
We are excited to see Phase 2 moving forward and grateful for the patience and support of our students, families, and staff during construction. These renovations will create modern, innovative spaces designed to enhance learning for our 6–12 grade students for years to come.
Our construction partner, Codell Construction, has provided updated maps to help families better understand the progress taking place and the timeline for each phase. We hope our updates spark excitement about the spaces we are building together for our school community!
For ongoing construction updates, visit our Fifth Street Renovation site: https://bisd.fyi/5thStreet
-
- Area A – A Wing classrooms
- Area B – Gymnasium
- Area C – Library and lower-level classrooms
- Area D – Cafeteria
Area A – A Wing Classrooms
The A Wing will be transformed into a hub for the arts. Classrooms will be redesigned for strings, chorus, band, and visual arts, creating specialized learning spaces that match the needs of our growing arts programs. Plans also include an outdoor performance space that will give students new opportunities to share their talents with our school and community.
-
- Anticipated demo start date: September 2025
- Anticipated completion date: March 2027
- Current progress: The Mechanical area demo is 90% complete. Once interior walls are removed and debris cleared, demolition of the catwalk and the center portion of the A Wing will begin.
Area B – Gymnasium
Renovations to the interior of the gymnasium will include painting, a new court, and a new scoreboard, providing students with updated athletic facilities.
-
- Anticipated start date: June 2026
- Anticipated completion date: October 2026
Area C – Library & Lower-Level Classrooms
The lower-level classrooms will receive a full renovation, including updated infrastructure and modernized learning spaces. The current library will be transformed into a science wing with labs for chemistry, biology, earth sciences, and physics, providing students with hands-on learning and exploration opportunities. During construction, the library will temporarily relocate to the Bardstown Polytechnic Center, with plans for a new library space in a future phase of the Fifth Street Renovation Project.
Area D – Cafeteria
The current cafeteria will be demolished to make way for a larger and more modern cafeteria designed to meet the needs of students and staff on this campus.
We are excited to see Phase 2 moving forward and grateful for the patience and support of our students, families, and staff during construction. These renovations will create modern, innovative spaces designed to enhance learning for our 6–12 grade students for years to come.
Our construction partner, Codell Construction, has provided updated maps to help families better understand the progress taking place and the timeline for each phase. We hope our updates spark excitement about the spaces we are building together for our school community!
For ongoing construction updates, visit our Fifth Street Renovation site: https://bisd.fyi/5thStreet
-
- Anticipated demo start date: September 2025
- Anticipated completion date: March 2027
- Current progress: The Mechanical area demo is 90% complete. Once interior walls are removed and debris cleared, demolition of the catwalk and the center portion of the A Wing will begin.
Area B – Gymnasium
Renovations to the interior of the gymnasium will include painting, a new court, and a new scoreboard, providing students with updated athletic facilities.
-
- Anticipated start date: June 2026
- Anticipated completion date: October 2026
Area C – Library & Lower-Level Classrooms
The lower-level classrooms will receive a full renovation, including updated infrastructure and modernized learning spaces. The current library will be transformed into a science wing with labs for chemistry, biology, earth sciences, and physics, providing students with hands-on learning and exploration opportunities. During construction, the library will temporarily relocate to the Bardstown Polytechnic Center, with plans for a new library space in a future phase of the Fifth Street Renovation Project.
Area D – Cafeteria
The current cafeteria will be demolished to make way for a larger and more modern cafeteria designed to meet the needs of students and staff on this campus.
We are excited to see Phase 2 moving forward and grateful for the patience and support of our students, families, and staff during construction. These renovations will create modern, innovative spaces designed to enhance learning for our 6–12 grade students for years to come.
Our construction partner, Codell Construction, has provided updated maps to help families better understand the progress taking place and the timeline for each phase. We hope our updates spark excitement about the spaces we are building together for our school community!
For ongoing construction updates, visit our Fifth Street Renovation site: https://bisd.fyi/5thStreet
-
- Area A – A Wing classrooms
- Area B – Gymnasium
- Area C – Library and lower-level classrooms
- Area D – Cafeteria
Area A – A Wing Classrooms
The A Wing will be transformed into a hub for the arts. Classrooms will be redesigned for strings, chorus, band, and visual arts, creating specialized learning spaces that match the needs of our growing arts programs. Plans also include an outdoor performance space that will give students new opportunities to share their talents with our school and community.
-
- Anticipated demo start date: September 2025
- Anticipated completion date: March 2027
- Current progress: The Mechanical area demo is 90% complete. Once interior walls are removed and debris cleared, demolition of the catwalk and the center portion of the A Wing will begin.
Area B – Gymnasium
Renovations to the interior of the gymnasium will include painting, a new court, and a new scoreboard, providing students with updated athletic facilities.
-
- Anticipated start date: June 2026
- Anticipated completion date: October 2026
Area C – Library & Lower-Level Classrooms
The lower-level classrooms will receive a full renovation, including updated infrastructure and modernized learning spaces. The current library will be transformed into a science wing with labs for chemistry, biology, earth sciences, and physics, providing students with hands-on learning and exploration opportunities. During construction, the library will temporarily relocate to the Bardstown Polytechnic Center, with plans for a new library space in a future phase of the Fifth Street Renovation Project.
Area D – Cafeteria
The current cafeteria will be demolished to make way for a larger and more modern cafeteria designed to meet the needs of students and staff on this campus.
We are excited to see Phase 2 moving forward and grateful for the patience and support of our students, families, and staff during construction. These renovations will create modern, innovative spaces designed to enhance learning for our 6–12 grade students for years to come.
Our construction partner, Codell Construction, has provided updated maps to help families better understand the progress taking place and the timeline for each phase. We hope our updates spark excitement about the spaces we are building together for our school community!
For ongoing construction updates, visit our Fifth Street Renovation site: https://bisd.fyi/5thStreet
